Business Operations • By Sysiphany Team, Systems Architecture & AI Implementation
• 11 min read

Throughput vs Capacity vs Utilization: Why a Busy Team Can Still Fall Behind

A practical comparison of completed output, conditional capacity, and resource occupation, with worked examples and a two-week demand-to-completion check.

DIAGNOSTIC SUMMARY
Symptom
The team appears fully occupied while incoming work exceeds accepted completions.
Pattern
Occupied hours, estimated completion capacity, and actual output are treated as interchangeable signals even when work mix, rework, and dependencies differ.
First Asset
A two-week demand, completion, and unfinished-work reconciliation that separates observed output from capacity assumptions and utilization definitions.
Copilot Role
Helping operators interpret rates and load without turning aggregate measures into unsupported bottleneck, staffing, or automation conclusions.

An architectural workbench contrasts a densely occupied working surface with a smaller collection of finished case files.

Throughput is the rate of completed work. Capacity is the rate a process can deliver under stated operating conditions. Utilization is how much of a named resource or capacity is being used. A team can be highly utilized and still fall behind when demand exceeds its completion rate, or when occupied hours go into work that has not reached an accepted finish.

A full calendar tells you that time is committed. It does not tell you whether the business is keeping its promises. For that, compare incoming work with accepted completions and the unfinished obligations left behind.

Quick answer: throughput vs capacity vs utilization

The measures answer different questions. Keep the item, period and denominator visible beside each number.

MeasureQuestionCalculation used hereInterpretation limit
ThroughputWhat actually finished?Accepted completions ÷ observation periodDoes not establish maximum capacity
CapacityWhat could this process deliver under specified conditions?Estimated feasible completions per periodDepends on skills, work mix, availability and dependencies
Time utilizationHow occupied was the named resource?Occupied work hours ÷ available work hours × 100Busy time can include correction and chasing
Demand loadHow much work is arriving relative to capacity?Arrival rate ÷ estimated completion capacity × 100Only meaningful for comparable work and periods
Work in progress (WIP)How much remains unfinished?Count inside the selected boundary at a stated timeAn inventory, not a rate or an explanation of delay

For the examples below, the boundary runs from request receipt to accepted completion. WIP includes received requests waiting to start as well as those being worked on. A tool that reserves “WIP” for started items will show a different inventory; call this broader count outstanding work if that avoids confusion.

This article interprets those measures together. If the underlying records do not yet support consistent counts, How to Measure a Business Process owns the initial baseline setup.

How do you calculate throughput, capacity, and utilization?

Count accepted completions to calculate throughput, state the assumptions behind any capacity estimate, and divide occupied time by the corresponding available time for time utilization. Those calculations should describe the same process without pretending to measure the same thing.

Consider an illustrative request-processing team, not a client result or an industry benchmark. Over a five-day week:

  • The team has 100 person-hours available for this process after leave and other committed duties.
  • Comparable cases are estimated to require two person-hours each through accepted completion, including normal checking and correction.
  • The work is assumed to be shareable across the team, with necessary skills, inputs and downstream acceptance available.
  • The team logs 90 occupied hours and delivers 40 accepted cases.
  • It receives 55 new requests of the same kind.

The arithmetic gives four different answers:

ViewCalculationResult
Observed throughput40 cases ÷ 5 working days8 completed cases per working day
Conditional capacity estimate100 person-hours ÷ 2 person-hours per case50 cases per week
Occupied-time utilization90 occupied hours ÷ 100 available hours90%
Incoming demand load55 requests ÷ 50 estimated weekly completions110% of estimated capacity

The 50-case figure is an hours-based estimate under explicit assumptions, not a promise to customers. It leaves no allowance for variation beyond the effort and availability already included. A scarce approval skill, uneven arrivals or extra correction can make that estimate too optimistic. Sustainable commitments need evidence across representative conditions, not just this division.

Nor can you assume the 40 completed cases consumed exactly 80 of this week’s hours. Some may have started earlier; some of the 90 occupied hours may belong to cases still open. The two-hour input is an estimate of total effort per comparable case, not a reconstruction of this week’s time records.

Why one report can say 90% and another 80%

An output-based capacity-utilization report would divide 40 completed cases by the 50-case capacity estimate and report 80%. The time report says 90%. Both calculations can be arithmetically correct because they use different numerators and denominators.

Label them “occupied-time utilization: 90%” and “output relative to estimated capacity: 80%.” Neither is interchangeable with billable utilization, which normally restricts the numerator to billable time under the business’s billing rules.

The unoccupied ten hours are not automatically spare capacity that can finish five more cases. They may occur when a required input is missing, belong to a different skill, or be scattered across intervals that cannot accommodate the work. Investigate before treating the remainder as sellable output.

If effort itself is disputed, Process Cycle Time vs Lead Time vs Touch Time separates human work from elapsed duration. Days spent open are not person-days of labor.

Why can high utilization make waiting worse?

When arrivals or service times vary, a heavily occupied resource has less room to absorb a burst or recover from a long case. Waiting can rise sharply as that resource approaches full use, even when average demand remains below nominal capacity.

The INFORMS tutorial Queues in Service Systems: Customer Abandonment and Diffusion Approximations, by J. G. Dai and Shuangchi He, explains this nonlinear relationship for single-server queues. The 2011 paper is available as an author copy hosted by Cornell University. Its service-system context includes call centers and customer abandonment; it is queueing theory, not a study of founder-led teams.

The same tutorial also explains why a large pool of parallel servers can combine high utilization with good service. That caveat matters. A single specialist, a small team with non-interchangeable skills and a large pooled contact center do not have the same capacity behavior. There is no universal utilization percentage in this article that makes all three safe.

Think of a specialist who has a full day’s scheduled reviews. One unexpectedly difficult review pushes later work back. If tomorrow is also fully committed, the delayed work has nowhere to go without moving another promise. That is a scheduling consequence, not evidence that the specialist is working too slowly.

High utilization does not prove poor performance, and reducing it does not automatically improve throughput. Stable, predictable work can run differently from variable service requests. The useful question is whether the named resource has room to meet the actual pattern of demand at the required quality and response time.

For SYSIPHANY, that changes what deserves attention: a team spending more time correcting incomplete inputs is not necessarily gaining useful capacity. Removing avoidable chasing can be more valuable than finding a faster way to perform it. Required checks still need to happen; activity should not become the goal simply because the time system can count it.

Mixed work can overturn a simple capacity comparison

Case counts are useful only when you understand what is inside them. Fifty short requests and fifty complex requests create the same count, not the same load.

Suppose standard requests require one person-hour and complex requests require three. In one illustrative week, 40 standard plus 10 complex requests require 70 person-hours. In another, 20 standard plus 30 complex requests require 110 person-hours. Both weeks contain 50 requests.

Against the same 100 available hours, the second mix exceeds the hours available even though the count has not changed. A flat “cases per week” target would miss that shift.

Keep materially different classes visible. Where reliable effort estimates exist, a workload estimate can add each class’s arrivals multiplied by its expected effort. Without those estimates, separate class counts are more honest than a precise-looking weighted total. Shared staff hours also cannot be counted in full against several processes at once.

Rework needs similar care. Correcting a returned case consumes capacity, but an internal correction is not a new customer outcome. Count its effort without inflating new-request arrivals or accepted output. If a previously completed case reopens, show that inventory adjustment explicitly rather than silently changing yesterday’s count.

Run a two-week demand, completion, and WIP check

Compare the work that entered, the work that reached accepted completion and the inventory still inside the boundary. Two weeks gives you a bounded observation, not a validated long-term capacity forecast.

Choose one existing process with usable records and keep its case boundary unchanged. At the start, count all outstanding requests. Over ten working days, capture arrivals and accepted completions, then count outstanding work at the same end-of-day time. Note material changes in work mix, staffing, operating hours and cancellations so the comparison has context.

The reconciliation is:

Closing WIP = opening WIP + arrivals − accepted completions, when nothing else enters or leaves the boundary.

If there are cancellations or transfers out, subtract them separately. Add transfers in or reopenings separately. Those adjustments explain inventory; they must not be relabeled successful completions. Keep refused or deferred demand outside the chosen boundary visible separately, or a stable internal queue may conceal unmet demand.

Here is a continuation of the illustrative example. There are no cancellations, transfers or reopenings, and the request class and completion rule stay unchanged.

ObservationWeek 1Week 2
Opening outstanding work2035
New requests received5560
Accepted completions4045
Closing outstanding work3550
Net growth in outstanding work1515

Completions increased from 40 to 45, yet the team fell further behind. Across the two weeks, 115 requests arrived and 85 finished. Outstanding work rose by 30 cases, from 20 to 50. The observed gap averaged 15 cases per week.

That gap is not a staffing calculation. It says how much the unfinished inventory grew under those observed conditions. It does not tell you which stage constrained delivery, whether the new work was harder, or how many additional people would change the result.

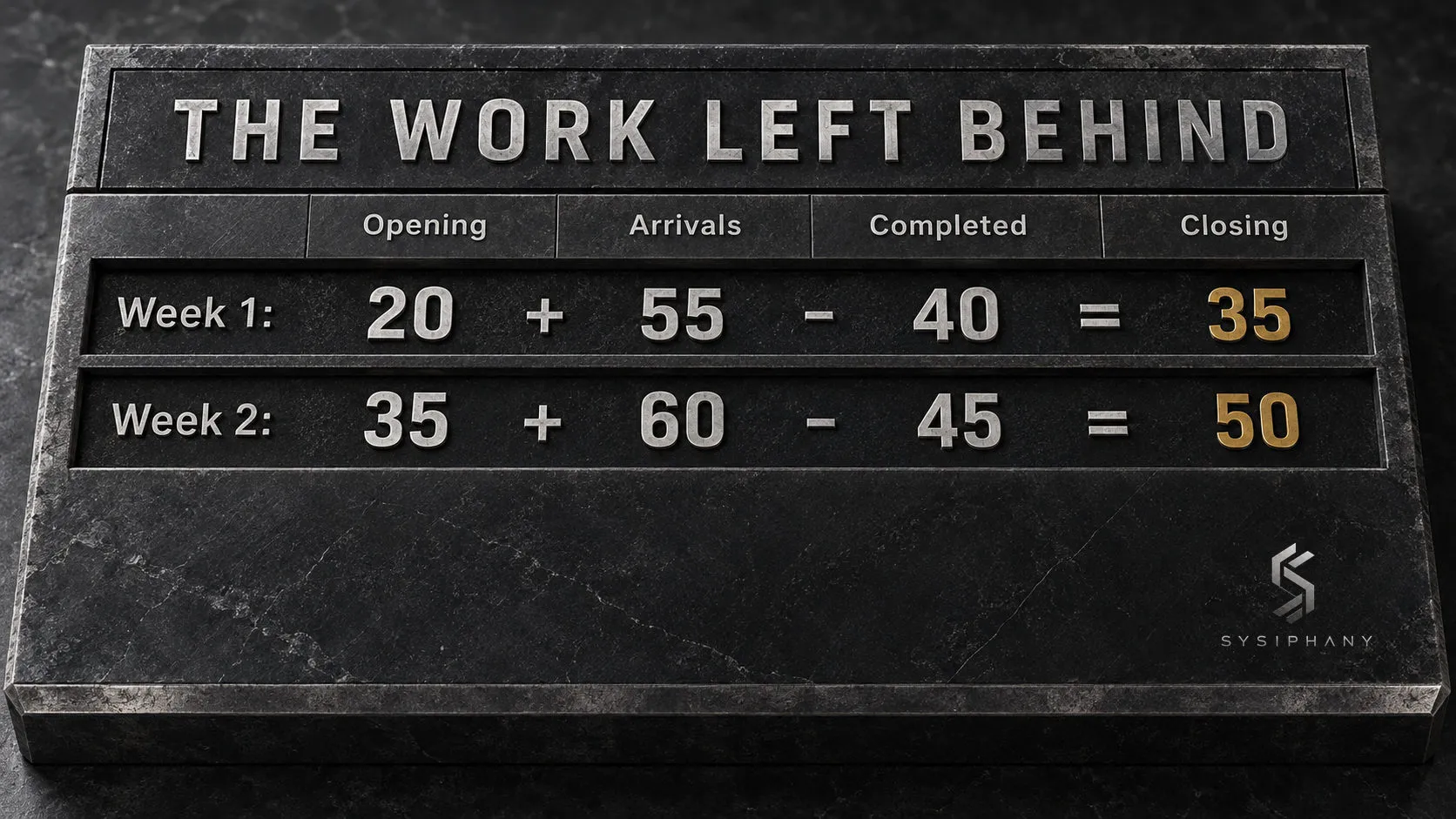

Two weekly inventory balances show completions rising while outstanding requests grow from 20 to 35 to 50.

What should you do with the result?

Start with what the counts establish, then choose the smallest check that could change your interpretation.

Observed patternWhat it establishesNext useful check
Arrivals exceed completions and WIP reconciles upwardUnfinished obligations grew during the windowReview near-term commitments against the observed gap; check whether demand and work mix are temporary or recurring
Demand exceeds a credible capacity estimateThe current assumptions imply insufficient capacity for that demandRecheck availability, effort and required skills before promising the excess; agree what may be deferred or reprioritized
Utilization is high while accepted output is lowOccupied time is not translating into the expected outputSeparate effort on unfinished work, correction and coordination; do not infer poor individual performance
Reported spare capacity coexists with growing WIPThe aggregate capacity view does not explain the inventory growthCheck skill/time mismatches and required dependencies; the spare hours may not be usable for waiting cases
Completions exceed arrivals and WIP fallsThe team is drawing down existing workCheck whether overtime or easier cases explain the result before treating it as sustainable capacity
Closing WIP does not reconcileEvents or boundaries are missing or inconsistentResolve transfers, reopenings, cancellations or duplicate records before drawing a load conclusion

A flat WIP count also deserves a look at the oldest open cases. Stable totals can hide old requests being left behind while newer, easier ones finish. This check flags that possibility; it does not diagnose the cause.

When the next question becomes where does work repeatedly stop?, move to How to Identify Bottlenecks in a Business Process. That investigation traces the constraint. The aggregate comparison above cannot locate it.

If conflicting records or hidden work prevent even this reconciliation, Download the Operational Drag Diagnostic Kit. Clarify which obligations the business is carrying before adding another reporting tool.

FAQ

Can utilization exceed 100%?

A planned load ratio can exceed 100% when assigned demand is greater than the stated capacity. Actual occupied time cannot exceed the matching available time without a definition change or recording problem. Overtime measured against a normal-hours denominator can produce a figure above 100%; label that denominator rather than calling it physical utilization.

Is throughput the same as productivity?

No. Throughput is completed output per unit of time. Labor productivity relates output to labor input, such as accepted cases per person-hour. Throughput can rise because more people worked, without productivity improving. Neither measure alone establishes quality or customer value.

Does low utilization mean the team is overstaffed?

No. It can reflect low demand, required standby coverage, unavailable inputs, a skill mismatch or an unsuitable denominator. The number is a prompt to inspect conditions. Scaling Operations Without Adding Headcount addresses the broader hiring-versus-operating-system decision.

Can I use WIP divided by throughput to promise a completion date?

Not from two weekly snapshots alone. An aggregate inventory-to-rate ratio does not account for an individual case’s priority, remaining work, dependencies or future arrivals. It is not a promise about when that case will finish.

What if the queue shrinks because customers cancel?

Report cancellations separately from accepted completions. A shrinking queue can coexist with lost demand and poor service. Otherwise the count may appear healthier precisely because customers stopped waiting.

Explain the gap before changing the target

Bring one sentence to the next operating conversation: “We received this much comparable work, completed this much, and ended with this much outstanding; our capacity estimate assumes these hours, skills and case mix.” Add the utilization definition only if it helps explain the difference.

That gives the team something firmer than “everyone looks busy.” If multiple teams disagree about available capacity, accepted completion or who can change delivery commitments, Book a SYSIPHANY discovery call. Start with the unresolved operating decision, not a request to make every hour look full.

#Business Processes #Process Measurement #Operational Clarity #Capacity Planning
Next Step // System Assessment

Ready to find where Operational Drag lives?

Download the Operational Drag Diagnostic Kit to map your invisible workflows, expose shadow systems, and evaluate your team's real AI readiness before adding more overhead.

Book a Discovery Call
Try Diagnostic AI Beta Diagnose operational friction
